Setup supply chain

For more information on supplier base setups, please refer to the Purchasing Training Manual.

Approved Supplier List

Approved supplier list is a controlled repository of information that links items and commodities to suppliers and supplier sites that provide them to a specific ship-to organization or to the entire enterprise.

Navigation path: Purchasing>Supply Base>Approved Supplier List

Refer to the table below for the setup of attributes relevant to planning.



Attribute Valid

values

Comment Setup
Status Approved,

Debarred, New

ASCP only consider Approved and not Disabled suppliers
Disabled
Global? Yes, No ASCP only plans PO for suppliers with

Global = Yes

Supplier planning constraints

Enhance sourcing provides the ability to model flexible supplier capacity.

Navigation path: Purchasing>Supply Base>Approved Supplier List>Attributes (B)> Planning Constraints (T)



Refer to the table below for the setup of attributes relevant to planning.



Attribute Comment Setup
Processing

Lead Time

This supplier-item attribute overrides the organization item attribute for processing lead time

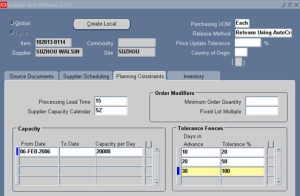

Supplier Capacity Calendar 1 Planning adjusts planned order release date so that deliveries occur on the valid delivery date that coincides with the due date or the closest valid delivery date that occurs prior to the due date. This calendar is independent

of your workday calendar.

Order

Modifiers

These supplier-item attributes override the organization

item attributes for order modifiers.

Capacity This supplier-item attribute represents supplier item daily

capacity in the purchasing UOM.

Tolerance Fence 2 Use the Tolerance% and Days Advance Notice attributes

together to state by what percentage a supplier can change capacity if given a number of days advance notice.



Note:

  1. If no calendar is defined and assigned to the supplier-item, planning will assume all days are acceptable for receiving.
  2. You can make multiple entries to represent the percentage change in capacity allowed with different days of advance notices.

Delivery calendar

Set up delivery calendar the same way as setting up workday calendar. Refer to Routing Training Manual on how to setup calendars.

The delivery calendar is used to establish valid delivery days by supplier, item, and organization. ASCP will offset planned purchase order release dates by the number of days in Processing Lead Time plus the number of days necessary to cause the delivery to your dock to occur on a valid delivery day.



If no delivery calendar is defined and assigned to the supplier-item, planning will assume all days are acceptable for receiving.
